السؤال

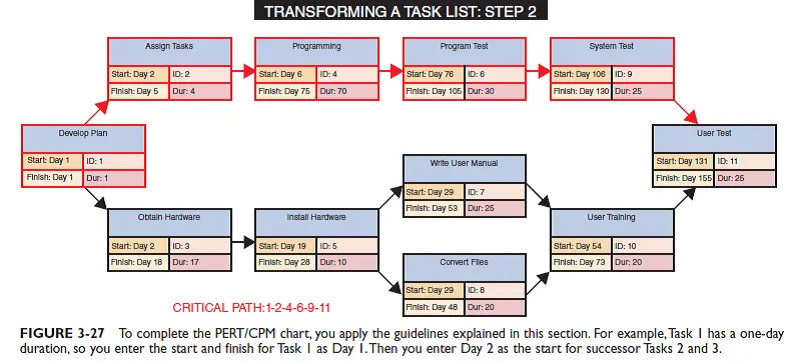

Transcribed Image Text:
Develop Plan
Start: Day 1
Finish: Day 1
ID: 1
Dur: 1
TRANSFORMING A TASK LIST: STEP 2
Start: Day 2
Assign Tasks
ID:2
Programming
Program Test
System Test
Finish: Day 5
Dur: 4
Start: Day 6
Finish: Day 75 Dur: 70
ID:4
Start: Day 76 ID:6
Finish: Day 105 Dur: 30
Start: Day 106 ID: 9
Finish: Day 130 Dur: 25
Obtain Hardware
Write User Manual
Start: Day 29
ID:7
Finish: Day 53 Dur: 25
Install Hardware
User Training
Start: Day 2
ID:3
Start: Day 19
ID:5
Finish: Day 18 Dur: 17
Finish: Day 28 Dur: 10
Convert Files
Start: Day 54
Finish: Day 73
ID: 10
Dur: 20
CRITICAL PATH:1-2-4-6-9-11
Start: Day 29
Finish: Day 48
ID:8
Dur: 20
User Test
Start: Day 131 ID: 11
Finish: Day 155 Dur: 25
FIGURE 3-27 To complete the PERT/CPM chart, you apply the guidelines explained in this section. For example, Task I has a one-day
duration, so you enter the start and finish for Task I as Day I.Then you enter Day 2 as the start for successor Tasks 2 and 3.
